Bull Run Wind Energy Center An introduction to: Invenergy Bull - - PowerPoint PPT Presentation

bull run wind energy center
SMART_READER_LITE
LIVE PREVIEW

Bull Run Wind Energy Center An introduction to: Invenergy Bull - - PowerPoint PPT Presentation

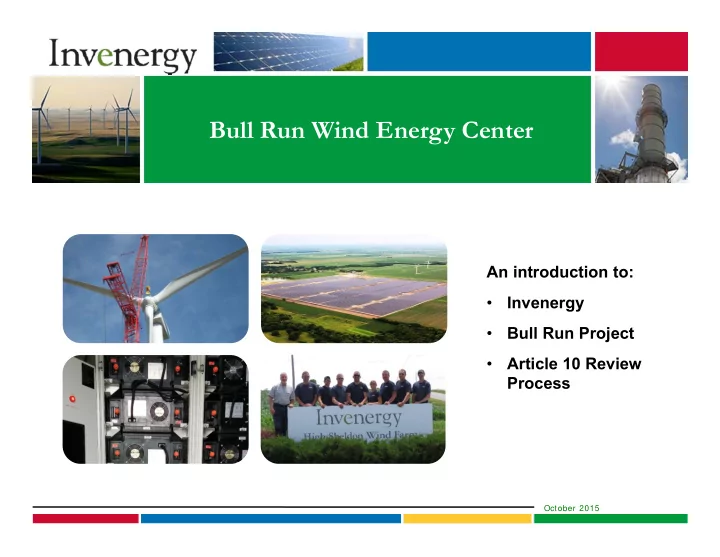

Bull Run Wind Energy Center An introduction to: Invenergy Bull Run Project Article 10 Review Process October 2015 Bull Run Wind Energy Center 50 to 100 Wind Turbines, 300 MW Developed, built, owned, and operated by


slide-1
SLIDE 1

October 2015

Bull Run Wind Energy Center

An introduction to:

  • Invenergy
  • Bull Run Project
  • Article 10 Review

Process

slide-2
SLIDE 2

2

October 2015

  • 50 to 100 Wind Turbines, 300 MW
  • Developed, built, owned, and operated by Invenergy
  • Estimated $5 Million per year in local benefits
  • 2018 Potential construction start
  • Environmental review by state agencies under the “new” Article 10

process

Bull Run Wind Energy Center

slide-3
SLIDE 3

3

October 2015

  • Clean – No CO2 emissions
  • Local – No fuel imports
  • Stable – No fuel price risk

Why Wind?

Coal Natural gas Nuclear Hydropower Biomass Geothermal Solar Wind Petroleum Other gases

2014 US Electricity Fuels (EIA)

4.4%

Markets Drivers for North Country Wind

  • NYSERDA Main Tier RPS (2016)
  • NY Next Generation RPS (2017?)
  • New England Clean Energy RFP (2016)
  • EPA Clean Power Plan (2018+)
  • Commercial & Industrial customers
slide-4
SLIDE 4

4

October 2015

  • Founded in 2001, Invenergy is headquartered in Chicago and

employs over 700 people globally.

  • Largest independent wind power company in North America;

recognized as a top-tier wind developer in the United States and Canada.

  • Wholesale electric power generation focus: wind, solar, natural gas,

storage.

  • Invenergy's senior executives - each with an average experience of

25 years in energy - have worked together as a core group for two decades.

About Invenergy

slide-5
SLIDE 5

5

October 2015

Invenergy Representatives

Eric Miller Project Developer Tom Hampston Local Representative Jon LaBarre Local Representative Patrick Doyle Consultant James Murphy VP Development, Canada Andrea Giampoli Permitting Specialist Ben Benfredj Engineering Harry Godfrey Public Relations & Government Affairs John Dax The Dax Law Firm, Albany

slide-6
SLIDE 6

6

October 2015

Sheldon 75 WTG 2009 Orangeville 58 WTG 2013 Marsh Hill 10 WTG 2014 Bull Run 50-100 WTG 2018?

slide-7
SLIDE 7

7

October 2015

Bull Run Project Area

Ellenburg Clinton Mooers Altona

Met1 Met2

slide-8
SLIDE 8

8

October 2015

$1,900,000 Land leases $1,500,000 PILOT ($5,000/MW) $ 900,000 HCA ($3,000/MW) $ 300,000 Fire Department taxes $ 500,000 O&M payroll Estimates assume 94 x 3.2 MW = 300.8 MW

Local Benefits

slide-9
SLIDE 9

9

October 2015

  • Land

– 18,000 acres under lease – Local office opened April 2015

  • Transmission studies underway
  • Two “Met” towers installed in June 2015
  • Field studies underway

– Birds, bats – Aerial surveys - topography (LIDAR), infrared photography – Cultural resources

  • Agency meetings – DPS, FWS, ACOE, DEC
  • Public outreach

– Town boards, Highway superintendents, Clinton county, IDA – Open house – www.BullRunWind.com – Canadian towns, border patrol – Adirondack Park, Nature conservancy

Development Activities

slide-10
SLIDE 10

10

October 2015

John Dax

The Dax Law Firm Albany, NY

What is Article 10? What is the Siting Board? Siting Board Approval Criteria Article 10 Process Funding for Participants Article 10 Documents Article 10

slide-11
SLIDE 11

11

October 2015

  • Grants the New York state board on electric generation siting and

the environment exclusive authority to approve the construction of new electric generating plants, including wind farms.

  • Creates a forum for the comprehensive examination of a proposed

generating facility’s public purpose; potential impacts, both positive and negative; and provisions for avoiding, minimizing and mitigating any negative impacts.

  • Replaces local municipal approvals that would normally be required.

What is Article 10?

slide-12
SLIDE 12

12

October 2015

  • The board on electric generating siting and the environment (the “Siting

Board”) is composed of heads of the following state agencies:

  • Department of Public Service (DPS)
  • Energy Research and Development Authority (NYSERDA)
  • Department of Environmental Conservation (DEC)
  • Department of Health
  • Empire State Development
  • Plus two “ad hoc” members who reside in the municipality
  • The Siting Board is staffed by experts from the DPS and DEC

What is the Siting Board?

slide-13
SLIDE 13

13

October 2015

The Siting Board may approve a proposed new facility only after: (1) Identifying the facility’s impacts on:

– the natural environment; – public health and safety; – recreational, historic and cultural resources; and – transportation and other infrastructure, and

(2) Finding that the facility:

– is a beneficial addition to the state’s electric generating grid, – will be in the public interest, – has been designed to minimize any adverse environmental impacts, – will operate in compliance with state and local laws

Siting Board Approval Criteria

slide-14
SLIDE 14

14

October 2015

  • Planning and public outreach

– Applicant identifies stakeholders and their concerns and questions and provides information about the project

  • Preliminary scoping

– Applicant, stakeholders, and agencies reach agreement on studies to be done

  • Application preparation, filing and public notification

– By Applicant

  • Application completeness review

– By Siting Board

  • Application review

– By stakeholders and state and local agencies, – Issue identification, hearing(s)

  • Decision by Board

The Article 10 Process

slide-15
SLIDE 15

15

October 2015

  • Bull Run will deposit funds to support participation in the Article 10

process by municipalities and local parties.

  • When?

– At the filing of the preliminary scoping statement – At the filing of the article 10 application

  • How much?

– Preliminary scoping − $105,000 – Application review − $300,000

  • Who may apply for funds?

– Local municipalities – Local residents and parties representing local residents

  • What may fund be used for?

– Hiring consultants, experts and lawyers to review documents, prepare analyses and participate in hearings

  • How are funds made available?

– Those seeking funds apply to the board’s hearing examiner with detailed plans for how the funds will be used

Funding for Participants

slide-16
SLIDE 16

16

October 2015

  • Public involvement plan
  • Scoping documents

– Pre-application preliminary scoping document – Summary of comments received from parties – Stipulations

  • Application for a certificate of environmental compatibility and public

need

  • Decision by Siting Board
  • Compliance filings

Article 10 Documents

slide-17
SLIDE 17

17

October 2015

  • Dec 2015. Aerial surveys complete
  • Feb 2016. Preliminary layout
  • Mar 2016. Article 10 Scoping Statement
  • Summer 2016. Field studies

– noise, wetlands, bats, archaeology, etc.

  • Fall 2016. Detail design
  • Dec 2016. Article 10 Application
  • June 2017. Article 10 Decision
  • Jan 2018. Transmission studies complete
  • May 2018. Start Construction

Bull Run Schedule Milestones

slide-18
SLIDE 18

18

October 2015

www.BullRunWind.com Contact: Eric Miller Director, Project Development 301-610-6413 emiller@invenergyllc.com
