19/6/01
- L. Maiani. Talk to the Staff
1

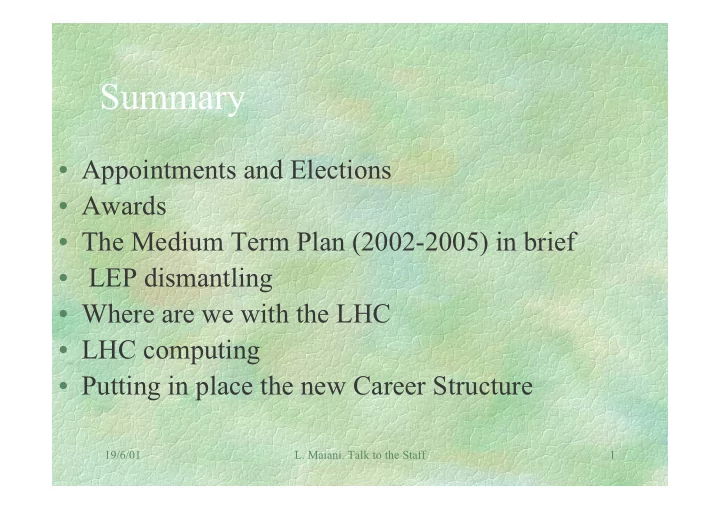

Summary
- Appointments and Elections
- Awards
- The Medium Term Plan (2002-2005) in brief
- LEP dismantling
- Where are we with the LHC
- LHC computing
- Putting in place the new Career Structure
Summary Appointments and Elections Awards The Medium Term Plan - - PowerPoint PPT Presentation
Summary Appointments and Elections Awards The Medium Term Plan (2002-2005) in brief LEP dismantling Where are we with the LHC LHC computing Putting in place the new Career Structure 19/6/01 L. Maiani. Talk to the Staff
19/6/01
1
19/6/01
2
19/6/01
3
19/6/01
4
19/6/01
5
19/6/01
6
19/6/01
7
LHC 64% Out&TT 0.3% Consolid 8% Support 19% Research 9%
19/6/01
8
Jan-04 Apr-04 Jul-04 Oct-04 Jan-05 Apr-05 Jul-05 Oct-05 Jan-06 Apr-06 Jul-06 Oct-06 Jan-07 Apr-07 Jul-07 Oct-07
Octant test 01/04 to 3 1 / 0 8 Last dipole delivered 3 1 / 0 3 Ring closed and cold 3 1 / 1 2 First beam 0 1 / 0 2 Physics run 7 months L>2x1033 0 1 / 0 8 2 8 / 0 2 Pilot run 01/04 to 30/04 Shutdown 3 months
Pb-Pb run 6 weeks
19/6/01
9
19/6/01
10
19/6/01
11
19/6/01
12
The β=0.7 4-cell prototype CERN technique of Nb/Cu sputtering for β=0.7, β=0.8 cavities (352 MHz):
(very important for pulsed systems)
tolerances, 4.5 °K operation with Q = 109 Bulk Nb or mixed technique for β=0.52 (one 100 kW tetrode per cavity)
0.1 1 10 2 4 6 8 10 12
Eacc [MV/m] Q/10
9
0.8 single cell LEP 0.7 4-cells 0.8 5-cells
19/6/01
13
2001 prices 2002 prices INCOME 971.5 982.8
Regular Contribution 944.9 956.2 CNGS Voluntary Contribution 17.8 17.8 Host States in-cash to LHC 2.0 2.0 Transfer from Reserve 5.0 5.0 Other Income 1.8 1.8
RUNNING EXPENDITURE 733.5 747.8 Personnel 455.2 464.3
Staff 423.6 432.1
25.0 25.5
Fellows & Associates 31.5 32.2
Materials Costs 255.9 260.6
LHC Operation 33.6 34.3 Other Operation 128.2 130.8 R&D 7.5 7.7 Non Recurrent 53.0 53.7
18.8 18.8
Energy 33.5 34.2
Debts 22.5 22.9 LHC CONSTRUCTION 324.6 331.1 Detectors 40.0 40.8 Machine & Areas 365.0 370.6
BALANCE
19/6/01
14
❧ Within the present severe budgetary constraints, the MTP will allow CERN to:
the intervening period
activities at a basic level. ❧ The level of support, maintenance and consolidation continues to be alarmingly low ❧ Resources for LHC computing infrastructure could not be identified in this plan and will require extra support from the Council. ❧ The long-term plan for human resources requires a revision, to allow CERN to develop fully the global role acquired with the LHC programme.
19/6/01
15
19/6/01
16
19/6/01
17
18
The Large Hadron Collider Lyndon Evans
Committee of Council meeting CERN, Geneva, 14 June 2001
19/6/01
19
Breakthrough of tunnel TI2 into the LEP near Point 2
19/6/01
20
❧ adjudications done so far are within cost estimates; about 70% committed, 30% paid; ❧ cost overruns related to the operations on site and to the execution of contracts have been detected, e.g. in civil engineering; ❧ Concerns 1: Civil engineering - Cost overruns particularly on package 3a and 3b
We are working with the contractors to minimize the cost. ❧ Concerns 2 - Superconducting cable delivery
maintaining the schedule. The situation will be reviewed before placing contracts for final dipole assembly.
19/6/01
21
0.00 500.00 1'000.00 1'500.00 2'000.00 2'500.00 D1995 D1996 D1997 D1998 D1999 D2000 D2001 D2002 D2003 D2004 D2005 D2006 Engagements BHT au 30-05/2001
1503 MCHF
Profil "Paiements" (CERN Budget)
2198 MCHF
Profil "Engagements Prévisionnels"
19/6/01
22
19/6/01
23
19/6/01
24
19/6/01
25
19/6/01
26
19/6/01
27
Name Quantity Purpose MB 1232 Main dipoles MQ 400 Main lattice quadrupoles MSCB 376 Combined chromaticity/ closed orbit correctors MCS 2464 Dipole spool sextupole for persistent currents at injection MCDO 1232 Dipole spool octupole/decapole for persistent currents MO 336 Landau octupole for instability control MQT 256 Trim quad for lattice correction MCB 266 Orbit correction dipoles MQM 100 Dispersion suppressor quadrupoles MQY 20 Enlarged aperture quadrupoles
19/6/01
28
19/6/01
29
In general good progress
to go into (mass) production
producing TDR’s as foreseen
proceed to TDR (total cross section, etc.)
(magnetic monopoles, ‘passive’ detector at LHCb) No major concerns, but: schedule, funding
and the resources are very tight…
June 11, 2001
19/6/01
30
Total Commitments for CMS Construction 55 3 4 52 66 75 90 9 46 57 59 124 180 255 345
10 20 30 40 50 60 70 80 90 100 95 96 97 98 99 00 01 02 03 04 05 06
Annual [MCHF]
100 200 300 400 500
Actual Annual Budget 2001 Draft Budget 2002 Future Annual Planned Profile Actual Cumulative Revised Profile
19/6/01
31
Total Payments for CMS Construction 59 3 2 20 43 75 90 12 7 65 80 69 127 202 292
10 20 30 40 50 60 70 80 90 100 95 96 97 98 99 00 01 02 03 04 05 06
Annual [MCHF]
100 200 300 400 500
Actual Annual Budget 2001 Draft Budget 2002 Future Annual Planned Profile Actual Cumulative Revised Profile
19/6/01
32
YE-1 & nose trial assembly Nov ‘00 In Kawasaki (Japan)
YB-2, YB-1, YB0 ready, YB1 started. Central wheel YB0, supporting the vacuum tank. Web camera: http://cmsdoc.cern.ch/outreach/
19/6/01
33
50 100 150 200 250 300 350 400 450 500 1995 1996 1997 1998 1999 2000 2001 2002 2003 2004 2005 2006 YEAR MCHF
Commitments as made
current prices Commitments as planned in MoU in '95 prices
19/6/01
34
50 100 150 200 250 300 350 400 450 500 1995 1996 1997 1998 1999 2000 2001 2002 2003 2004 2005 2006 YEAR MCHF
Payments as made or presently planned in current prices Payments as planned in MoU in '95 prices
19/6/01
35
B0 coil connected to the barrel toroid test stand in Hall 180 at CERN
19/6/01
36
Cooled Si sensors in secondary vacuum Openings for feedthrough flanges (25’000 pins)
25 cm 120 cm
Exit window 1.5-2 mm thick Al RF/Vacuum thin shield Vertex detector half
Regular reviews by the LHC machine group: 1st review: 3-4 April 2001 (very positive and constructive) 2nd review foreseen in February 2002
19/6/01
37
0.5 1.0
Sigma 70 ps 0.5% later than 250 ps 0.06 % later than 500 ps 0.65% earlier than 250 ps Counts per 50 ps 103 102 10 1 MAXIM 3760 Time [ns]
19/6/01
38
19/6/01
39
19/6/01
40
❧ The LHC computing review (end 1999 - 22 Feb 2001) has identified the requirements for a full exploitation of LHC data by all participating institutes and physicists. ❧ world-wide Grid-computing system. CERN capacity ~1/3 of the total. ❧ The developments, installations and resources required at CERN cannot be satisfied within the present budget. The Management therefore proposes a two-phased approach, covering the years 2001 to 2007
prototype, to be discussed now;
discussed later on the basis of the findings of phase 1.
19/6/01
41
http://www.datagrid.cnr.it/
Project start 01-01-01, duration 3 years, 6 principal partners, 3 industries, 12 further partners Deliverables: Middleware tried out with Particle Physics-, Earth Observation-, Biomedical Applications Applications - Distributed Fabrics - "Transparent" Grid Middleware Grids will have prominent role in the IST part of FP 6 of EU EU-interest to extend to other regions: US, Japan, Russia, . . ., GGF 1 Early start into LHC Computing Grid developments !!
19/6/01
42
les.robertson@cern.ch
Estimated CPU Capacity required at CERN
1,000 2,000 3,000 4,000 5,000 1998 1999 2000 2001 2002 2003 2004 2005 2006 2007 2008 2009 2010
Jan 2000: 3.5K SI95
Other experiments
K SI95 Moore’s law –
some measure of the capacity technology advances provide for a constant number of processors or investment
19/6/01
43
year Thousands of CERN Units IBM 9000 mainframe decomissioned
Moore's law (based on 1988)
SHIFT Project at CERN
19/6/01
44
Mainframe
Mini- Computer
vector Supercomputer
19/6/01
45
20 40 60 80 100 120
1988 1990 1992 1994 1996 1998 2000
year Thousands of CERN Units Mainframes decomissioned First PC services
Moore's law (based on 1988)
CERN RD47 project RISC decomissioning agreed
19/6/01
46
Estimated resources for Computing Services at CERN
Infrastructure (non-physics)
non-LHC share of base physics svcs & infrastr.
LHC share of base physics services & infrastructure Physics WAN
Computer centre refurbishment
Prototype Outsourced administration &
Tier 0 investment Tier 1 investment
10 20 30 40 50 60 2001 2002 2003 2004 2005 2006 2007 2008 year MCHF
Funding available (MTP)
Engineering & accelerator services (see note) Infrastructure services (non-physics) Physics support - non-LHC LHC share of infrastructure services Baseline LHC phys svcs LHC services & software -
Fabric & Grid mgmt s/w R&D
Software & applications R&D
50 100 150 200 250 1999 2000 2001 2002 2003 2004 2005 2006 2007 2008 year FTEs
DataGRID funding Complement
note: The numbers in this category correspond to the situation at the end of January 2001. They are higher than the figures used in the LHC Computing Review due to a shift in responsibilities to IT from the Technical and Accelerator sectors
19/6/01
47
Project Leader
The LHC Computing Grid Project
LHCC Project Overview Board Project Execution Board Software and Computing Committee (SC2) Work Plan Definition WP RTAG WP WP WP WP Common Computing RRB Resource Matters Multi- Science Industry Other Computing Grid Projects DataGRID Project Reviews Reports
19/6/01
48
19/6/01
49
19/6/01
50
19/6/01
51
s
A B C D E F G
Aa Ab Ac Ba Bb Bc Ca C b Cc Da D b Dc Ea Eb Ec Fa Fb Fc Ga G b Gc increment = increment = increment = increment = increment = increment = 86 89 98 89 98 111 98 111 130 111 130 151 130 151 181 181 210 239 239 296 376 F0 3650 F0 4457 F0 4778 F0 5445 F0 6326 F1 3736 F1 4546 F1 4876 F1 5556 F1 6456 F2 3822 F2 4635 F2 4974 F2 5667 F2 6586 3908 4724 5072 5778 6716 9338 12644 13448 15081 1 3994 1 4813 1 5170 1 5889 1 6846 1 9519 1 12883 1 13744 1 15457 2 4080 2 4902 2 5268 2 6000 2 6976 2 9700 2 13122 2 14040 2 15833 3 4166 3 4991 3 5366 3 6111 3 7106 3 9881 3 13361 3 14336 3 16209 4 4252 4 5080 4 5464 4 6222 4 7236 4 10062 4 13600 4 14632 4 16585 5 4338 5 5169 5 5562 5 6333 5 7366 5 10243 5 13839 5 14928 5 16961 6 4424 6 5258 6 5660 6 6444 6 7496 6 10424 6 14078 6 15224 6 17337 7 4510 4546 7 5347 5366 7 5758 5778 7 6555 6586 7 7626 7683 7 10605 10755 7 14317 7 15520 7 17713 8 4596 1 4635 8 5436 1 5464 8 5856 1 5889 8 6666 1 6716 8 7756 1 7834 8 10786 1 10965 8 14556 8 15816 9 4682 2 4724 9 5525 2 5562 9 5954 2 6000 9 6777 2 6846 9 7886 2 7985 9 10967 2 11175 9 14795 9 16112 10 4768 3 4813 10 5614 3 5660 10 6052 3 6111 10 6888 3 6976 10 8016 3 8136 10 11148 3 11385 10 15034 10 16408 11 4854 4 4902 11 5703 4 5758 11 6150 4 6222 11 6999 4 7106 11 8146 4 8287 11 11329 4 11595 11 15273 12 4940 5 4991 12 5792 5 5856 12 6248 5 6333 12 7110 5 7236 12 8276 5 8438 12 11510 5 11805 13 5026 6 5080 13 5881 6 5954 13 6346 6 6444 13 7221 6 7366 13 8406 6 8589 13 11691 6 12015 7 5169 5170 7 6052 6111 7 6555 6586 14 7332 7 7496 14 8536 7 8740 7 12225 12225 8 5258 1 5268 8 6150 1 6222 8 6666 1 6716 8 7626 7683 8 8891 8976 8 12435 1 12464 9 5347 2 5366 9 6248 2 6333 9 6777 2 6846 9 7756 1 7834 9 9042 1 9157 9 12645 2 12703 10 5436 3 5464 10 6346 3 6444 10 6888 3 6976 10 7886 2 7985 10 9193 2 9338 10 12855 3 12942 11 5525 4 5562 11 6444 4 6555 11 6999 4 7106 11 8016 3 8136 11 9344 3 9519 11 13065 4 13181 12 5614 5 5660 12 6542 5 6666 12 7110 5 7236 12 8146 4 8287 12 9495 4 9700 12 13275 5 13420 13 5703 6 5758 6 6777 13 7221 6 7366 13 8276 5 8438 13 9646 5 9881 6 13659 7 5856 7 6888 14 7332 7 7496 14 8406 6 8589
14 9797
6 10062 7 13898 8 5954 8 6999 8 7626 15 8536 7 8740 15 9948 7 10243 8 14137 9 6052 9 7110 9 7756 8 8891 8 10424 9 14376 10 6150 10 7221 10 7886 9 9042 9 10605 10 14615 11 6248 11 8016 10 9193 10 10786 12 6346 12 8146 11 9344 11 10967 13 8276 12 9495 12 11148 14 8406 13 9646 13 11329 14 9797 14 11510
(
6444 ) 7332 ) 8589 )
(
10062 )
(
11805 )
(
7110 ) 8146 ) 9495 )
(
11148 )
(
13065 ) = FEP
=1 step/2 years
=EAZ
19/6/01
52
19/6/01
53
19/6/01
54
