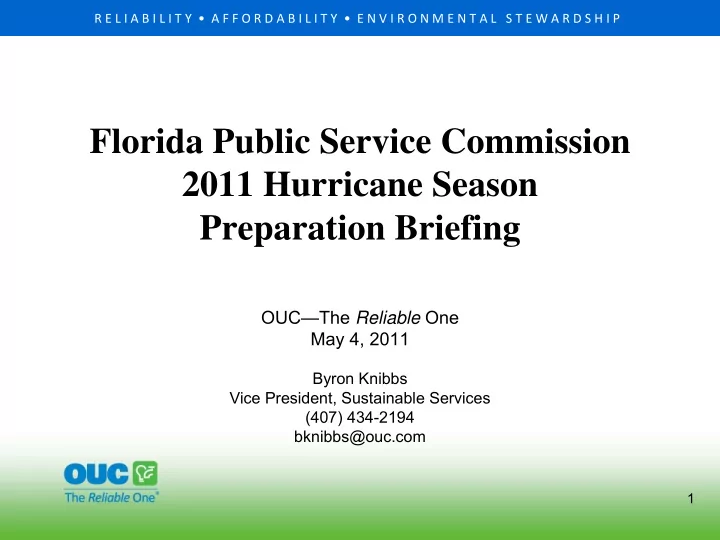

R E L I A B I L I T Y A F F O R D A B I L I T Y E N V I R O N M E N T A L S T E W A R D S H I P Florida Public Service Commission 2011 Hurricane Season Preparation Briefing OUCThe Reliable One May 4, 2011 Byron Knibbs Vice


slide-1
SLIDE 1

1 R E L I A B I L I T Y • A F F O R D A B I L I T Y • E N V I R O N M E N T A L S T E W A R D S H I P

Florida Public Service Commission 2011 Hurricane Season Preparation Briefing

OUC—The Reliable One May 4, 2011

Byron Knibbs Vice President, Sustainable Services (407) 434-2194 bknibbs@ouc.com

slide-2
SLIDE 2

2 R E L I A B I L I T Y • A F F O R D A B I L I T Y • E N V I R O N M E N T A L S T E W A R D S H I P

Florida Municipal Electric Utilities

Winter Park

slide-3
SLIDE 3

3 R E L I A B I L I T Y • A F F O R D A B I L I T Y • E N V I R O N M E N T A L S T E W A R D S H I P

OUC Electric System

Orlando Service Area Orlando Service Area

Orange County Orange County

  • St. Cloud Service Area
  • St. Cloud Service Area

Osceola County Osceola County

OUC System Statistics

Service Area = 394 Square Miles Electric Customers = 235,559

222,512 Residential 13,047 Commercial

Water Customers = 91,704

83,985 Residential 7,719 Commercial

slide-4
SLIDE 4

4 R E L I A B I L I T Y • A F F O R D A B I L I T Y • E N V I R O N M E N T A L S T E W A R D S H I P

OUC Electric Distribution System OUC Electric Distribution System

Overhead vs. Underground Statistics Overhead vs. Underground Statistics Overhead Pole Miles 1,358 (40%)

Wood poles = 77% Concrete poles = 23%

Underground Conduit Miles 1,939 (60%) Total Miles 3,297

slide-5
SLIDE 5

5 R E L I A B I L I T Y • A F F O R D A B I L I T Y • E N V I R O N M E N T A L S T E W A R D S H I P

OUC Electric Transmission System OUC Electric Transmission System

Statistics Statistics Total 69 kV Transmission Miles 48 Total 115 kV Transmission Miles 276 Total 230 kV Transmission Miles 70 Total Transmission Miles 394

Wood poles = 15% Steel or Concrete poles = 85%

Substations 36

Distribution Feeders = 269

slide-6
SLIDE 6

6 R E L I A B I L I T Y • A F F O R D A B I L I T Y • E N V I R O N M E N T A L S T E W A R D S H I P

OUC System Design & Hardening Standard

Construction Standards

– 80% of new distribution construction is underground – Transmission and Distribution facilities are constructed to NESC 120 mph extreme wind loading standards (NESC 140 mph extreme wind loading at the coast) – Ensure “foreign” utility attachments meet OUC design and wind loading standards – Loop Design distribution underground circuits – Redundant circuits to key critical customers with automatic transfer scheme – All new and replacement transmission poles are steel or concrete

slide-7
SLIDE 7

7 R E L I A B I L I T Y • A F F O R D A B I L I T Y • E N V I R O N M E N T A L S T E W A R D S H I P

OUC Reliability-Centered Maintenance Program

Vegetation Management

– Davey Tree – 10 crews – Four-year Distribution System trimming cycle

  • 1,296 Miles of overhead

Distribution Lines

  • Trim 324 Miles per year

– Annually inspect trees on main feeders for fast growers – Three-year Rural and One-year Urban Transmission System trimming cycle

  • 362 Miles of overhead Transmission Lines
  • Trim 100 Miles per year
slide-8
SLIDE 8

8 R E L I A B I L I T Y • A F F O R D A B I L I T Y • E N V I R O N M E N T A L S T E W A R D S H I P

OUC Reliability-Centered Maintenance Program

Preventive and Predictive Preventive and Predictive Maintenance Maintenance

  • 6.7°C
16.6°C
  • 5
5 10 15 AR01 30.3°C 37.0°C 32 34 36 AR01

Overhead ■ Visually & Infrared Inspect all main feeders annually Underground ■ Infrared manholes and devices of commercial areas

  • n predetermined cycle

Facilities Maintenance

(Distribution and Transmission)

– Four Inspectors (Vegetation, Pole inspection, Pole electrical hardware) – Five Distribution Maintenance Crews – Two Transmission Maintenance Crews – Inspect wood poles based on an eight-year cycle – Annual visual and infrared inspection

  • f all main feeders
slide-9
SLIDE 9

9 R E L I A B I L I T Y • A F F O R D A B I L I T Y • E N V I R O N M E N T A L S T E W A R D S H I P Typical Overhead Distribution Inspection Results

Identified Work Orders Complete

Pole Replacement 654 585 Lightning Arresters 298 298 Primary Connections 60 60 Primary Insulators 50 50 Secondary 108 108 Primary Static 21 21 600A Primary Switches 33 33 Primary Insulating T- Bracket 65 65 Cross Arm 124 124 Transformer 100 100 Totals 1,471 1,444

OUC Reliability-Centered Maintenance Program

Facilities Maintenance

(Distribution and Transmission) – Produces an average of 1,471 Distribution system work orders per year – Produces an average of 60 Transmission system work orders per year

slide-10
SLIDE 10

10 R E L I A B I L I T Y • A F F O R D A B I L I T Y • E N V I R O N M E N T A L S T E W A R D S H I P

OUC Reliability Performance OUC Reliability Performance

Tracking Performance

– Daily outage reports via email to the CEO, Vice Presidents, Key Customer Accounts Representatives and Media Relations – 7 a.m., 2 p.m. and 10 p.m. – Instant notification via email to the CEO and Operations Vice Presidents for circuit feeders lockouts and power plants unscheduled outages – Outage Map on OUC Website (www.ouc.com) – Track Performance using Florida Public Service Commission Reliability Index

slide-11
SLIDE 11

11 R E L I A B I L I T Y • A F F O R D A B I L I T Y • E N V I R O N M E N T A L S T E W A R D S H I P

10 20 30 40 50 60

Minutes

SAIDI 9-Year Average = 43 Minutes

SAIDI 42.6 54 47.5 54.2 36.9 41.8 32.6 37.6 38.2 2002 2003 2004 2005 2006 2007 2008 2009 2010 System Average Interruption Duration Index SAIDI = Sum of all customer minutes interrupted Total number of customers served

OUC Reliability Performance Trending OUC Reliability Performance Trending

slide-12
SLIDE 12

12 R E L I A B I L I T Y • A F F O R D A B I L I T Y • E N V I R O N M E N T A L S T E W A R D S H I P

2 4 6 8 10 12 14

Momentary Interruption Events

MAIFIe 9-Year Average = 8.6 Events

MAIFIe 13.4 10 8.8 8.8 7.8 7.6 7.3 7.5 6.7 2002 2003 2004 2005 2006 2007 2008 2009 2010

Momentary Average Interruption Frequency Index - Event MAIFIe = Sum of all customer momentary interruption events Total number of customers served

OUC Reliability Performance Trending OUC Reliability Performance Trending

slide-13
SLIDE 13

13 R E L I A B I L I T Y • A F F O R D A B I L I T Y • E N V I R O N M E N T A L S T E W A R D S H I P

Storm Preparation

Emergency Operations – Adopted the National Incident Management System (NIMS) – Operates under Incident Command System (ICS) – Constructed a new Incident Command Center – Established liaisons at Cities and Counties Emergency Operations Center (EOC) – Purchased Logistics Tracking software – “Resources on Demand” – Installed new 800 MHz Radio System – Updated Integrated Voice Response (IVR) System

slide-14
SLIDE 14

14 R E L I A B I L I T Y • A F F O R D A B I L I T Y • E N V I R O N M E N T A L S T E W A R D S H I P

Emergency Operation Plan – Annual review of Emergency Operation Response Procedures – Procedures are updated as needed – Employee storm assignments reviewed annually – Training/Refresher classes conducted annually – Critical customer list reviewed and updated – Annual Hurricane tabletop exercises – Due to the critical nature of the electric and water facilities, OUC will be holding terrorist tabletop exercises with the Orlando and Orange County EOC’s – Plan established to walk neighborhoods, if necessary (ex. damaged weatherhead)

Storm Preparation

slide-15
SLIDE 15

15 R E L I A B I L I T Y • A F F O R D A B I L I T Y • E N V I R O N M E N T A L S T E W A R D S H I P

– Mutual Aid Agreements reviewed annually

  • Florida Municipal Electric Association
  • Florida Municipal Utilities
  • American Public Power Association
  • National Municipal Utilities
  • Florida Electric Coordinating Group
  • Florida Municipal, IOU and Cooperative Utilities

– Contracts are established or renewed annually with Electrical and Tree Trimming Contractors

  • Terms and pricing are settled prior to Hurricane season

– Annual review of potential equipment and material vendors

  • Terms and pricing are settled prior to Hurricane season

– Contracts established with local radio and television stations for before, during and after the storm “customer communication” – Community storm preparation meetings

Storm Preparation

slide-16
SLIDE 16

16 R E L I A B I L I T Y • A F F O R D A B I L I T Y • E N V I R O N M E N T A L S T E W A R D S H I P

Questions
