ACCC Public Forum 18 March 2004 18 March 2004 George Maltabarow - - PowerPoint PPT Presentation

accc public forum
SMART_READER_LITE
LIVE PREVIEW

ACCC Public Forum 18 March 2004 18 March 2004 George Maltabarow - - PowerPoint PPT Presentation

ACCC Public Forum 18 March 2004 18 March 2004 George Maltabarow Maltabarow George Acting Managing Director Acting Managing Director Issues Issues 1. ACCC process 1. ACCC process 2. ACCC Regulatory Framework 2. ACCC Regulatory Framework


slide-1
SLIDE 1

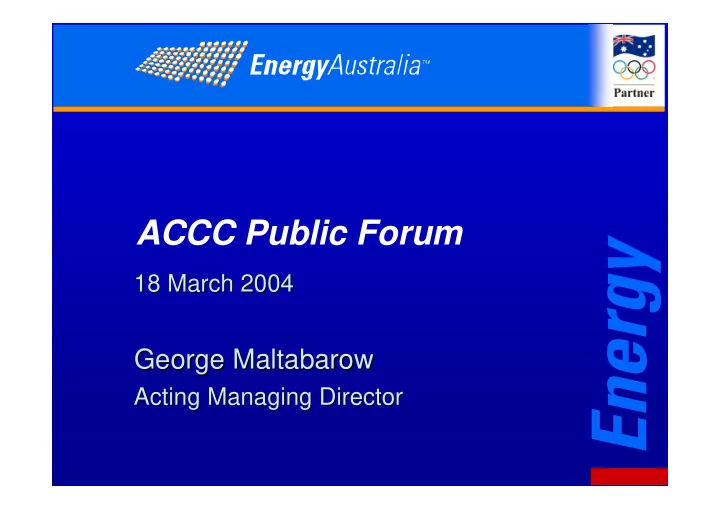

ACCC Public Forum

18 March 2004 18 March 2004

George George Maltabarow Maltabarow

Acting Managing Director Acting Managing Director

slide-2
SLIDE 2

2

Issues Issues

  • 1. ACCC process
  • 1. ACCC process
  • 2. ACCC Regulatory Framework
  • 2. ACCC Regulatory Framework
  • 3. Response to Supplementary Draft
  • 3. Response to Supplementary Draft
slide-3
SLIDE 3

3

ACCC process ACCC process

Initial application - September 2003 Draft Determination - April 2004 Supplementary Draft - March 2005 9 months into the regulatory period we have: – no final determination in place

derogation in place for pricing purposes

– continued framework uncertainty – questions over code compliance of supplementary draft determination

slide-4
SLIDE 4

4

ACCC Framework ACCC Framework

  • Initially ACCC proposed

Initially ACCC proposed “ “firm firm” ” cap cap

  • EA supports move away from firm cap

EA supports move away from firm cap

  • However, EA believes

However, EA believes “ “modified cap modified cap” ”is designed is designed to limit capital investment to limit capital investment

slide-5
SLIDE 5

5

ACCC Framework ACCC Framework

  • ACCC argues that new framework alleviates need

ACCC argues that new framework alleviates need to review to review “ “every nut and bolt every nut and bolt” ”

  • EA believes ACCC has abandoned notion of

EA believes ACCC has abandoned notion of economic incentives driving performance economic incentives driving performance

  • utcomes
  • utcomes
  • Instead,

Instead, ACCC ACCC’ ’s s strategy is to second strategy is to second-

  • guess

guess management and technical expertise of utilities management and technical expertise of utilities

  • Regulation has become intrusive and regulates

Regulation has become intrusive and regulates behaviour rather than performance behaviour rather than performance

  • Is this what

Is this what Hilmer Hilmer had in mind? had in mind?

slide-6
SLIDE 6

6

ACCC Framework ACCC Framework

  • ACCC now makes project by project decisions

ACCC now makes project by project decisions

  • ACCC puts itself in the shoes of the utility, the

ACCC puts itself in the shoes of the utility, the management & the Board management & the Board

  • BUT where is

BUT where is ACCC ACCC’ ’s s accountability when things accountability when things go wrong? go wrong?

slide-7
SLIDE 7

7

Price impact Price impact

  • ACCC rejected $100m

ACCC rejected $100m capex capex for EA for EA

  • Price impact of including full

Price impact of including full capex capex ($283m) is: ($283m) is:

– – $0.82 per year on average end user $0.82 per year on average end user’ ’s bill s bill – – or 1.6 cents per week

  • r 1.6 cents per week
  • Very concerning that ACCC risks network failure

Very concerning that ACCC risks network failure for such a marginal benefit to consumers for such a marginal benefit to consumers

slide-8
SLIDE 8

8

Case study: Ourimbah STS Case study: Ourimbah STS

  • EA proposed replacement due to aged equipment

EA proposed replacement due to aged equipment and loading and loading

  • ACCC recommended that Ourimbah be deferred

ACCC recommended that Ourimbah be deferred

  • Consequences are significant for Central Coast

Consequences are significant for Central Coast residents if substation fails residents if substation fails

  • 49,000 customers could face blackouts

49,000 customers could face blackouts

  • Impact could be avoided for extra:

Impact could be avoided for extra:

– – 15 cents per year on final bills 15 cents per year on final bills – – or 0.3 cents per week

  • r 0.3 cents per week
slide-9
SLIDE 9

9

ACCC Framework ACCC Framework

  • Main cap allowance

Main cap allowance

– – ACCC has moved away from FIRM cap ACCC has moved away from FIRM cap

  • Excluded projects

Excluded projects

– – ACCC trying to cater for uncertain capital ACCC trying to cater for uncertain capital

– regime itself uncertain regime itself uncertain

– 5 5-

  • year incentive period is not supported

year incentive period is not supported

– Regime cannot be implemented properly under Code Regime cannot be implemented properly under Code

slide-10
SLIDE 10

10

ACCC Framework ACCC Framework

  • Re

Re-

  • opener mechanism
  • pener mechanism

– – Not subject to consultation Not subject to consultation

– Not consistent with current Code Not consistent with current Code

– Cannot be implemented without Code change Cannot be implemented without Code change

– Replaces the pass Replaces the pass-

  • through rules

through rules

– Reduces flexibility of framework Reduces flexibility of framework

slide-11
SLIDE 11

11

So what have we achieved? So what have we achieved?

Initial draft (April 2004) EA’s revised submission Supplementary draft (March 2005) Forecast capex $184m $283m $182m Total revenues $509m $517m $501m Firm cap

  • Pass-through
  • Code compliance
  • ?
slide-12
SLIDE 12

12

The Supplementary Draft The Supplementary Draft

  • $65m cut to replacement program

$65m cut to replacement program

  • Represents 40% of what we sought

Represents 40% of what we sought

  • Cuts are not sustainable in long term

Cuts are not sustainable in long term

  • $35m project excluded (but not funded)

$35m project excluded (but not funded)

slide-13
SLIDE 13

13

191919241929 19341939194419491954195919641969197419791984198919941999 200420092014 5 Year Period Ending 30 June

Replacement Cost $‘millions (2002)

Capital Depreciation

Capex cycle: replacing assets built in 1960s

slide-14
SLIDE 14

14

Age profile of EA Transmission network

M$ 0 M$ 50 M$ 100 M$ 150 M$ 200 M$ 250 M$ 300 M$ 350 M$ 400 Pre-1934 (70+) 1940 - 1944 (60 - 64) 1950 - 1954 (50 - 54) 1960 - 1964 (40 - 44) 1970 - 1974 (30 - 34) 1980 - 1984 (20 - 24) 1990 - 1994 (10 - 14) 2000 - 2004 (0 - 4) Year installed (age now) Replacement cost Substations Pow er Transformers 132kV underground 132kV ov erhead 66kV overhead (M$ 2004 real) Assets currently reaching end-of-life

SKM report on replacement

slide-15
SLIDE 15

15

Capex reduction Capex reduction

  • $65m rejected through PB desk top review

$65m rejected through PB desk top review

– – EA brought SKM in to verify the replacement strategy EA brought SKM in to verify the replacement strategy – – SKM proposed higher levels of replacement than put by EA SKM proposed higher levels of replacement than put by EA

  • replacement strategy represents justified middle ground

replacement strategy represents justified middle ground

  • Replacement of critical elements denied by ACCC

Replacement of critical elements denied by ACCC – – aging transformers & switchgear aging transformers & switchgear denied denied – – 70 year old OH line 70 year old OH line denied denied – – Ourimbah STS Ourimbah STS denied denied

  • unacceptable level of safety and reliability risks

unacceptable level of safety and reliability risks

slide-16
SLIDE 16

16

Next steps Next steps

  • EA responded to

EA responded to ACCC ACCC’ ’s s initial draft in July 04 initial draft in July 04

  • ACCC has not addressed

ACCC has not addressed EA EA’ ’s s response to: response to:

– – cuts to cuts to opex

  • pex

– – rejection of past rejection of past capex capex

Step 1 Step 1 -

  • Address outstanding issues

Address outstanding issues Step 2 Step 2 -

  • Improve workability of excluded projects

Improve workability of excluded projects framework framework Step 3 Step 3 -

  • Deliver final determination in time for

Deliver final determination in time for 2005 2005-

  • 2006 prices

2006 prices
