Beaubassin Mikmaq Wind Prosperity Conference April 10 th , 2015 Slide 1 Presentation Overview Mikmaq Renewable Energy Strategy Assembly COMFIT projects: Chronology of Amherst/Whynots Mikmaq Resource Development Partnership


slide-1
SLIDE 1

Slide 1

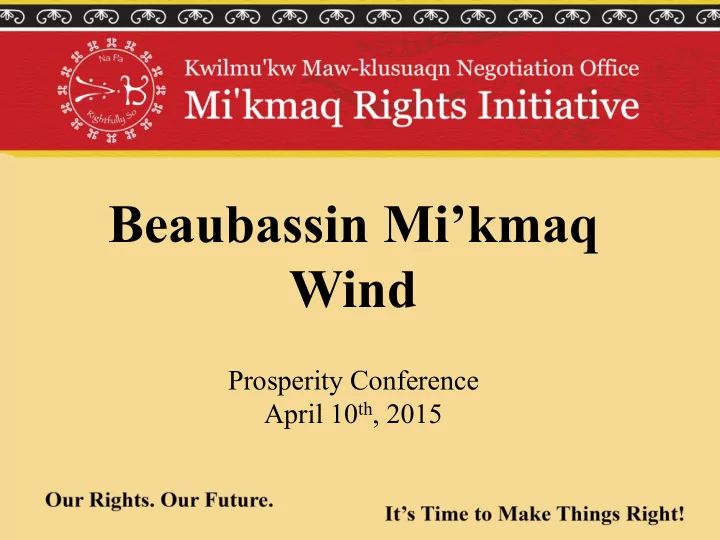

Beaubassin Mi’kmaq Wind

Prosperity Conference April 10th, 2015

slide-2
SLIDE 2

Slide 2

  • Mi’kmaq Renewable Energy Strategy
  • Assembly COMFIT projects: Chronology of Amherst/Whynots
  • Mi’kmaq Resource Development Partnership (MRDP)
  • Questions

Presentation Overview

3/26

slide-3
SLIDE 3

Slide 3

  • Designed to undertake an analysis in three primary areas. Potential

projects (COMFIT), Mi’kmaq Energy Usage and Policy

  • Stantec Consulting engaged in Aug 2010.
  • Project Delivered in April 2011. Assembly approves final draft in July

2011.

  • MRES reviewed wind and grid resources for all 13 communities and

satellite communities.

  • Reviewed potential for large and small wind, Biomass, tidal and run of

river

Mi’kmaq Renewable Energy Strategy

6/26

slide-4
SLIDE 4

Slide 4

  • Captured and Analyzed (for the first time) actual Mi’kmaq usage data from NS

power.

  • MRES revealed that the Mi’kmaq (on average) use close to 2 times the power

that average Nova Scotian’s use on an annual basis.

  • Became the driver for Mi’kmaq Energy Efficiency Project
  • Delivered to all 13 Mi’kmaq communities from May –December 2013
  • Total installs of energy efficient products equals 1640 Mi’kmaq homes.
  • Over 2.0 million kwhs per year saved or $ 280,000.00 in annual savings (at current rates)

MRES continued

7/26

slide-5
SLIDE 5

Slide 5

September 2011: Assembly approves a plan presented by the KMKNO with agreement from the P&P committee to investigate potential wind project developers that may be seeking partnerships under the Comfit program. October: Project partner review. December 2011: Assembly agrees to enter into LOI with Juwi Wind (Whynotts Project) and Natural Forces (Amherst Project) April 12, 2012: Province approves Whynotts project. June 2012: Partnership officially signed/EA/MEKS Underway October 2013: Turbine Contract signed/EA submitted Dec 2013: Prime contractor selected August 2014: Turbines erected/Four sites October 31st: Turbines operational Nov 17th: opening ceremony

Wind Projects: Whynotts Settlement

10/26

slide-6
SLIDE 6

Slide 6

  • December 2011: Assembly approves Natural Forces
  • Three firms bidding on Amherst site. All three seek Mi’kmaq partnership
  • June 2012: DOE request competing partners (Juwi/Sprott/Natural Forces) to present project proposals. DOE to review

projects and make a recommendation.

  • June 2012, DOE recommends Natural Forces. Assembly reviews recommendation with all three firms
  • July 2012: Assembly selects Natural Forces
  • Initial site adjacent to existing Sprott turbines (Marsh)
  • 2013: Province changes EA regulations affecting Amherst Corridor/Noise levels
  • Sept 2013: Assembly injects project equity/Launches MRDP
  • Feb 2014: MRDP/Beaubassin select new Amherst site/EA/DSS/Wind campaign/MEKS underway (July)

Wind Project: Amherst

10/26

slide-7
SLIDE 7

Slide 7

MI’KMAQ RESOURCE DEVELOPMENT PARTNERSHIP

  • Officially launched in August 2013
  • Set up as a General Partnership between all thirteen communities
  • All profits distributed equally to 13 Mi’kmaq communities.
  • Initially set up as a holding company for wind projects.
  • Board of Directors (Beaubassin Mi’kmaq Wind) first meeting Feb 2014
  • Directors immediately begin to develop new projects and partnerships including Compass ESS/Efficiency NS
  • MRDP/Beaubassin to develop new companies, including finance and Energy Efficiency company in 2015
slide-8
SLIDE 8

Slide 8

THANK YOU QUESTIONS
